Lab note 2026-07-07

Knowing the moment a forecast is ready

Forecast production is a factory assembly line, a fulfillment center, and a delivery route all in one. Lewis Fry Richardson's Weather Forecasting Factory was not too far off.

“Weather Forecasting Factory” by Stephen Conlin, 1986. Based on the description in Weather Prediction by Numerical Process, by L.F. Richardson, Cambridge University Press, 1922, and on advice from Prof. John Byrne, Trinity College Dublin. Image: ink and water colour, c. 50 x 38.5 cm. © Stephen Conlin 1986. All Rights Reserved. (Courtesy: Hendrik Hoffmann, School of Mathematics & Statistics, University College Dublin. Source)

Every dataset in the dynamical.org catalog (so far) is downstream of a model run that someone else produces on their own cadence. And the initialization is just the beginning (literally and philosophically). Then the files start landing, one by one, eventually trickling in over tens of minutes (or even hours) rather than appearing all at once. If your pipeline depends on that data, you have two bad options: pretend you can divine a cron schedule that will "always work," or poll wildly.

And to add to that, we had questions like:

We sought to answer these questions and many more so that the dynamical.org catalog would be resilient, low-latency, and designed around the minute details of its upstream sources. The prompt for actually sitting down and answering them was a question Will Hobbs posted on LinkedIn about NOAA model file availability.

So, we built a tool called wxopticon to remove that guesswork (I pronounce it "waxopticon", and I say it in a slightly mischievous voice and picture Saruman reaching for the Palantir — no, not THAT Palantir. Oh never mind). It watches upstream weather sources and dynamical.org's own catalog stores, and it answers three operational questions:

You can see all of this on the pipeline status page.

The second component is a system that enables consumers to create subscriptions (via webhooks, Slack notifications, etc.) to meaningful events (e.g., "notify me when IFS ENS progress:f024 is complete" or "warn me when GEFS on AWS looks like it might arrive late").

How it works, briefly

wxopticon is a set of stateless functions over a single append-only event log in object storage. The log is the source of truth, and everything else (the dashboard, status and timing, the readiness milestones) is a pure replay of it.

A lean detection scan runs every two minutes: it replays the log to find the runs still expected, probes their upstream locations, appends any new state transitions, and fans each new milestone out to subscribers. A separate summarize pass runs every five minutes to refresh the status feed and seed "delayed" signals. For products with a notification stream (e.g., AWS SNS), a continuous listener catches arrivals within seconds instead of waiting for the next scan.

What a year of arrivals actually looks like

Because every arrival is in the log, we can replay the whole dang thing. Over the last year, wxopticon recorded roughly 1.9 million file arrivals across 9,150 completed product-runs of thirteen upstream feeds.

A run arrives over time. The moment a run starts and the moment it's complete can be many hours apart, and the shape of that arrival looks different for every model.

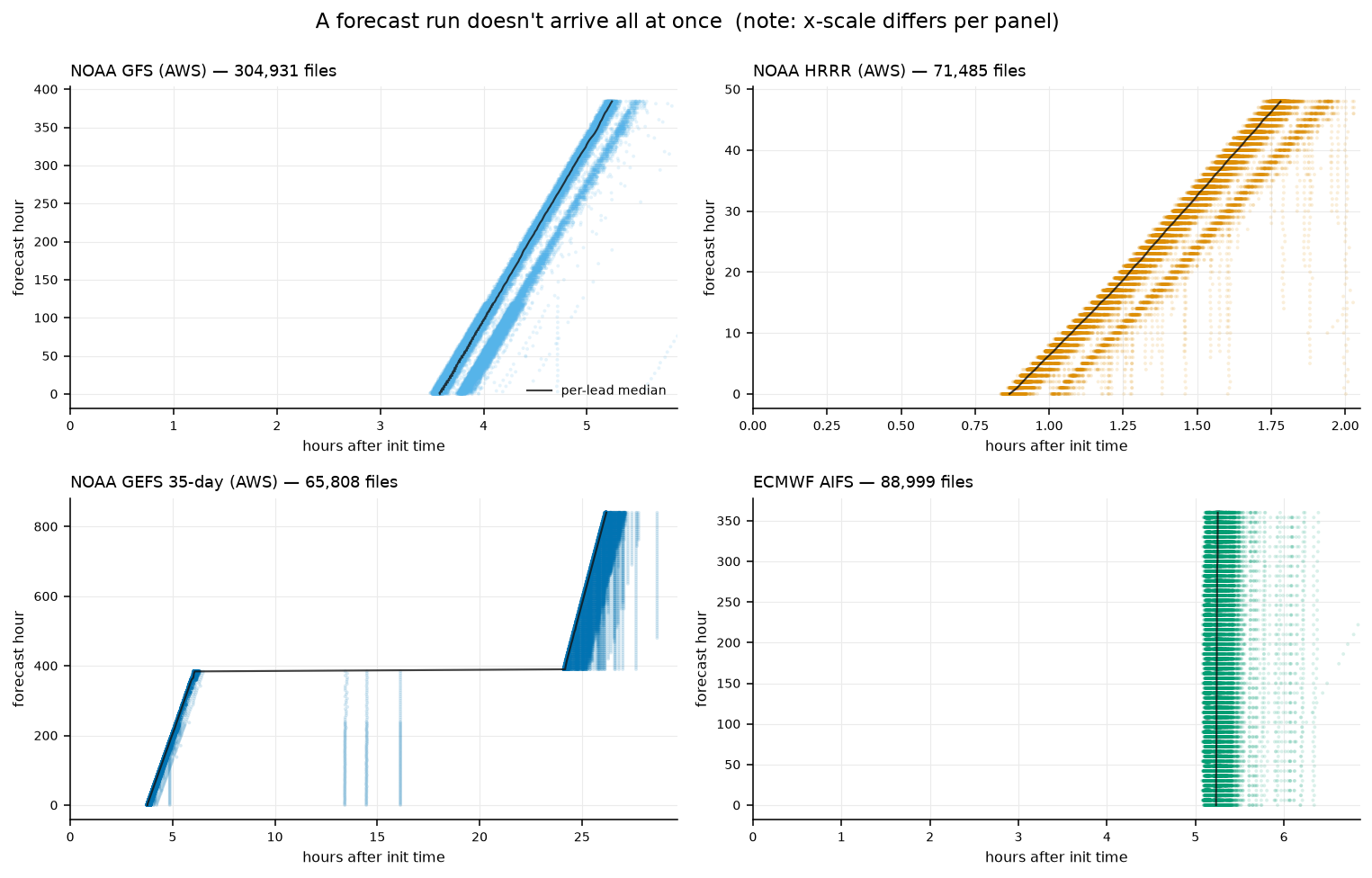

Scatter plots for four models, each point a forecast file positioned by its forecast hour (vertical) against hours after init time (horizontal). GFS traces a long diagonal, HRRR a tight one, GEFS two slopes with a plateau, AIFS a near-vertical band.
Every file found over the last year, by forecast hour and time since init; the dark line is the per-lead median. GFS trickles out its 16 days of forecasts over two hours; HRRR climbs through its 48 hours in one; GEFS sprints to day 16, then delivers the 35-day tail a day later; AIFS drops everything at once. (Some rewritten timestamps clipped.)

This is why "ready" is a series of milestones; a short-range consumer can start using GEFS the instant the early lead groups land, long before the full run completes.

The feeds are punctualish! Measured from init time to the last file of the run, the median completion time is about 1h47m for HRRR, 3h37m for DWD's ICON-EU, 5h15m for AIFS, 5h22m for GFS, and a full ~26h for GEFS's 35-day run.

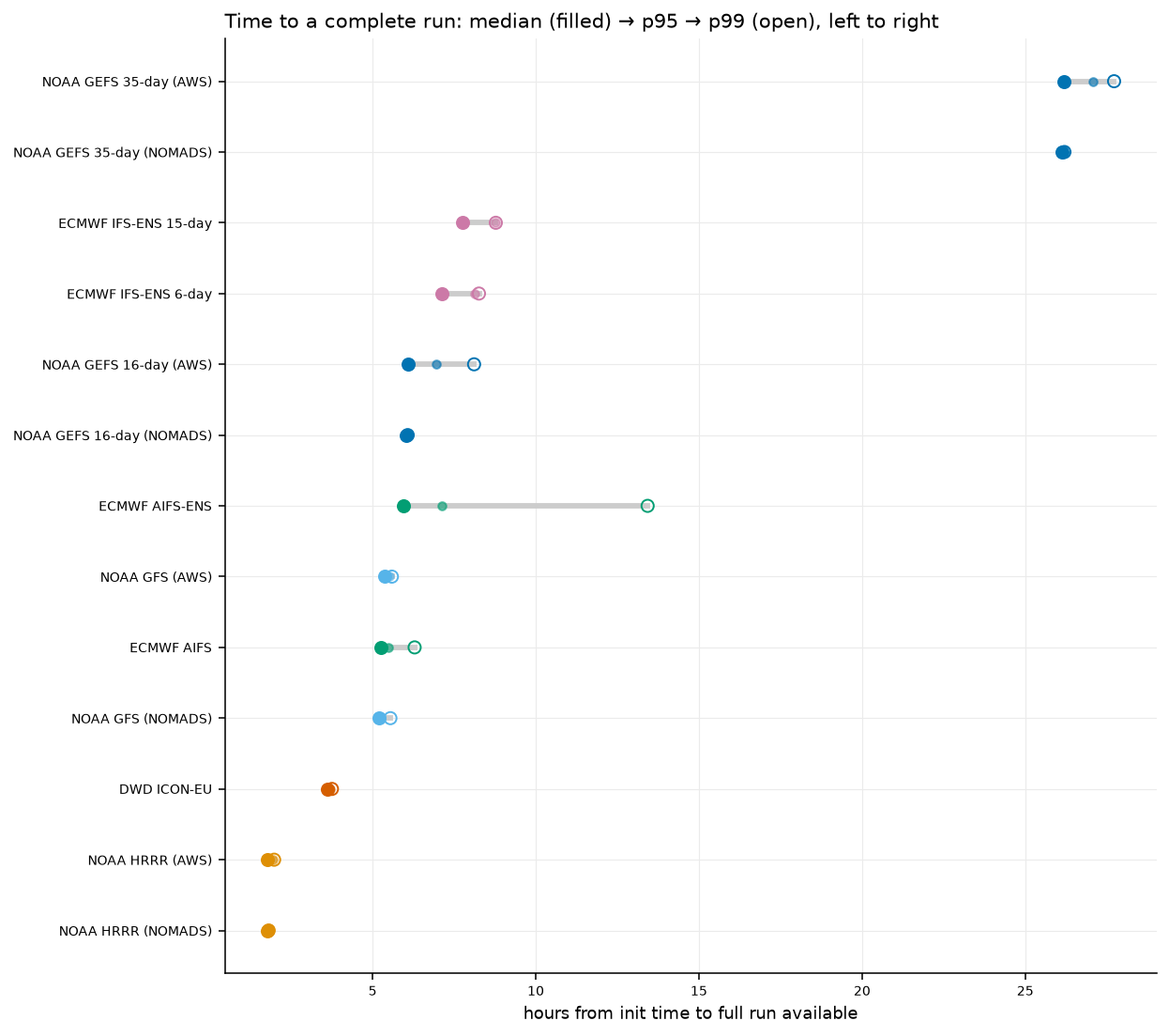

A dumbbell chart ranking thirteen feeds by time from init to a complete run, from HRRR near two hours to GEFS 35-day near 26 hours, each showing median, 95th and 99th percentile.
Init to complete run: median (filled) through the 95th to the 99th percentile (open). The striking part is how narrow most of these ranges are.

GFS completes within a 13-minute band from its median to its 99th percentile, run after run. Regularity is exactly what makes a learned next-run expectation meaningful. A "late" signal is useful because on-time performance is so consistent.

What "ready" actually means

wxopticon models each run's progress as a sequence of readiness boundaries. Rather than a single "done" flag, a run crosses named milestones as its lead hours become available:

kind fires when
progress every lead ≤ an intermediate lead-group horizon is available (e.g., progress:f240)
complete the full run is available — you don't need to know group names
in_flight a still-running run is behind its learned schedule
advisory the upstream agency opens or resolves a dissemination advisory

That table describes events, not run states. We initially mixed those concepts together, which made it hard to say whether delayed meant "still running" or "finished, but late." The current model has two orthogonal axes:

I went back and forth on the correct threshold for "delayed." Our first pass split the question in two: an in-flight run was delayed at p95 plus one minute, while a completed run was judged against p99. Raw p95 was obviously too harsh: by definition, it would flag roughly one ordinary run in twenty. But adding one minute still hugged very consistent feeds too tightly, and p99 was a volatile tail statistic answering a different question.

We replayed a year of arrivals and compared several buffers above p95:

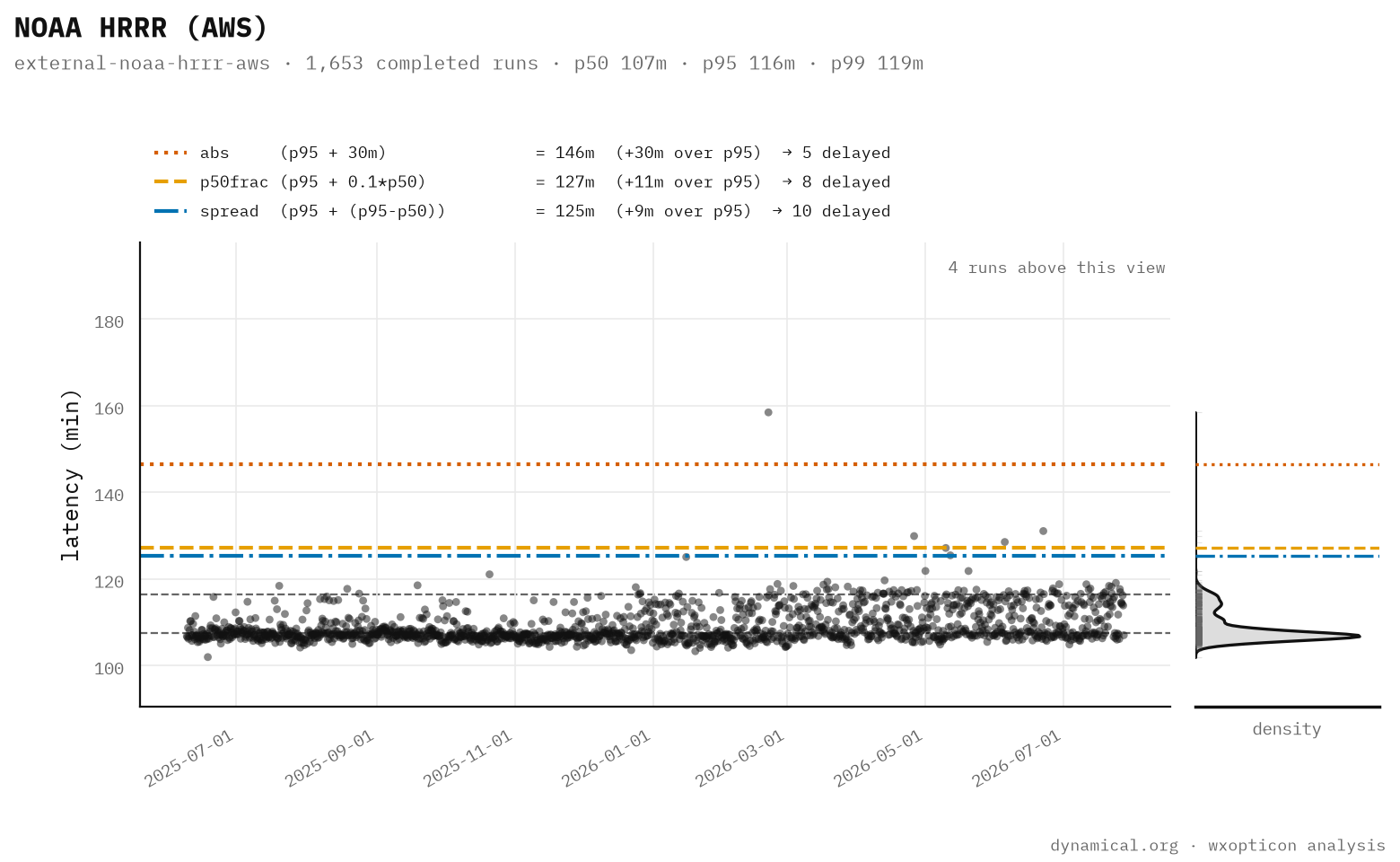

A scatter plot of 1,653 HRRR-on-AWS runs, each point one run's completion latency against its date. The runs form a dense band between about 105 and 120 minutes. Three horizontal candidate lines cross the plot: a dash-dotted line at 125 minutes just above the band, a dashed line at 127, and a dotted line at 146 far above everything. A density curve along the right edge shows the packed band.
Three candidates, three answers: 125, 127, and 146 minutes, flagging 10, 8, and 5 of 1,653 runs. HRRR's median and p95 sit 9 minutes apart, so raw dispersion lands where routine jitter crosses it. A flat 30 minutes is a 28% cushion here — and 2% on GEFS's 26-hour run.

The challenge was to come up with something formulaic that behaved sensibly across tight and wide distributions. What worked best was something not on our original list: a dispersion buffer with a floor:

spreadf = p95 + max(p95 - p50, 15 minutes)

Each product gets its own spreadf from a trailing 90-day window. Each lead group gets one too. This is useful: if GFS is still working toward day 10 after its day-10 group would normally be ready, wxopticon can mark the run in_flight and delayed before the full 16-day run reaches its later deadline. The event names the lead group that triggered the warning.

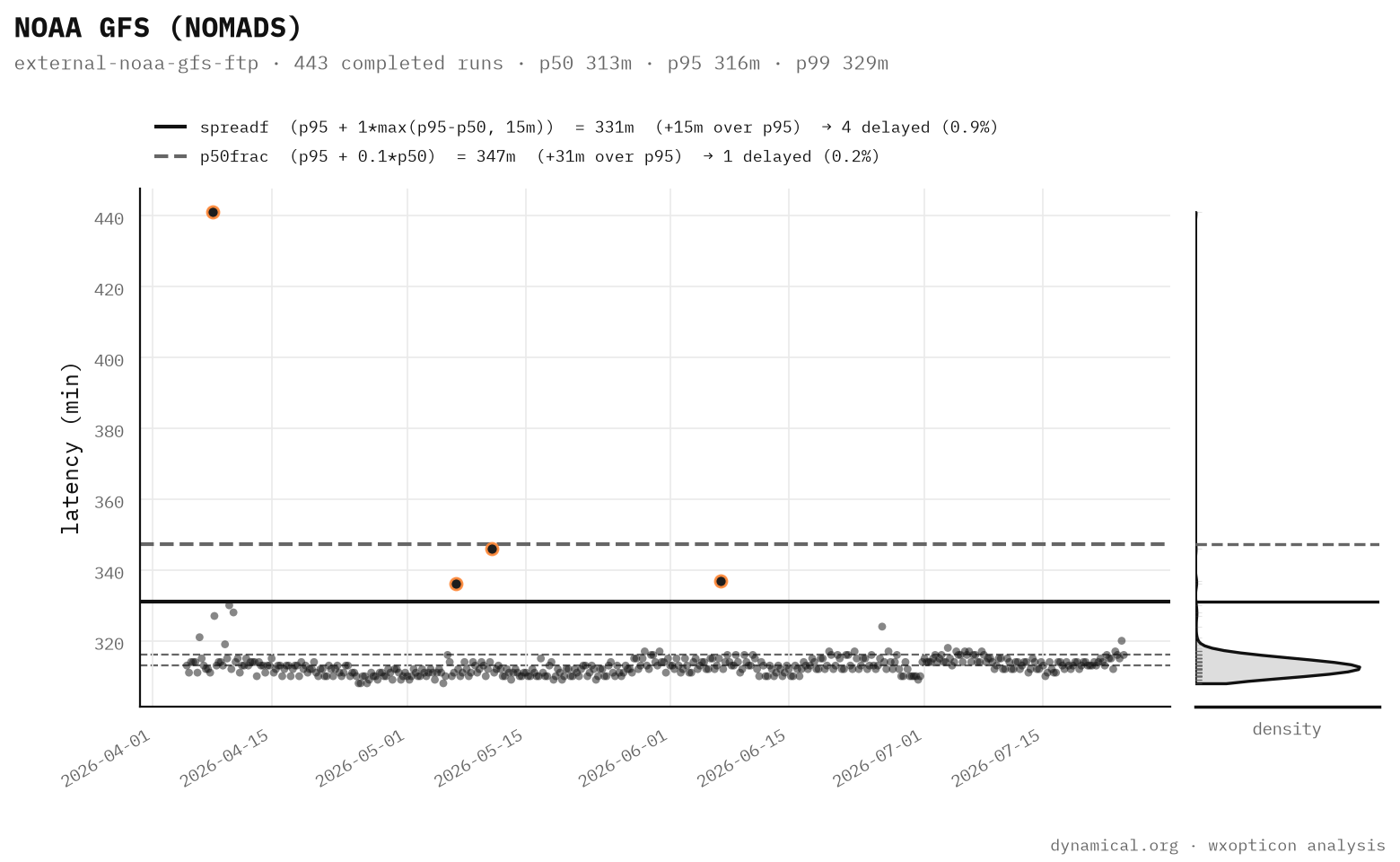

A scatter plot of 443 GFS-on-NOMADS runs, each point one run's completion latency against its date. Almost every run sits in a flat band near 313 minutes; four sit above it, one as high as 441. Two horizontal lines cross the plot: a solid spreadf line at 331 minutes with four points above it, and a dashed p50frac line at 347 minutes with one point above it. A density curve along the right edge shows how tightly the band is packed.
The floor earns its keep on our tightest feed: GFS on NOMADS puts 3 minutes between median and p95. Unfloored, dispersion would sit at 319 and flag 10 ordinary runs. `spreadf` lifts it to 331 (solid) and catches the four real stragglers; `p50frac` at 347 (dashed) sees only the worst.

The spreadf approach now drives the dashboard, in-flight warnings, and the completed run's timing.

Can a delayed lead-group predict a delayed run?

We also wanted to explore the question: can delayed lead groups foretell the full run being delayed? Using the spreadf methodology, lead groups produced 46 observable early warnings, or about 0.5% of runs:

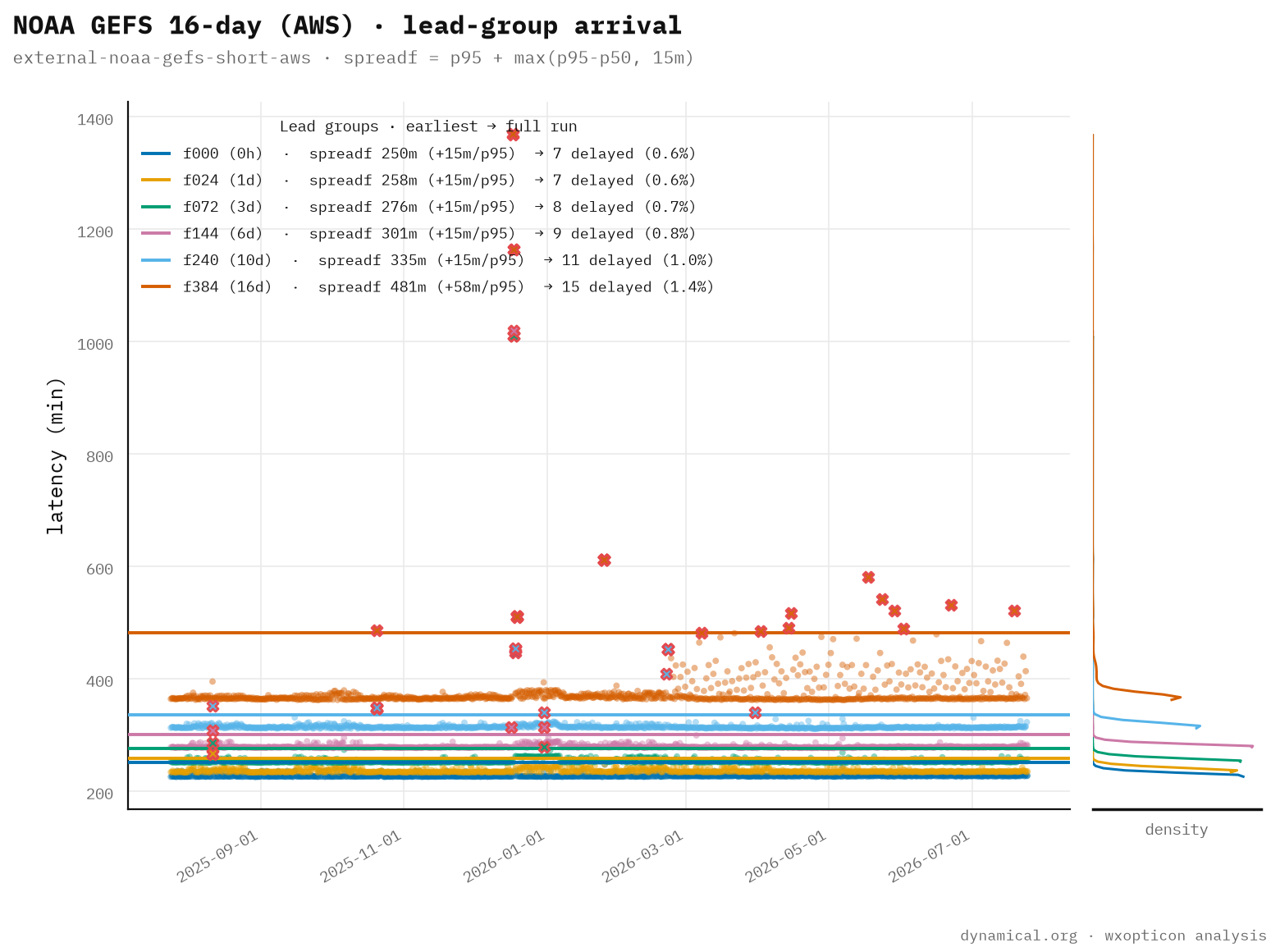

A scatter plot of GEFS 16-day arrivals on AWS over a year, colored by lead group. Six horizontal bands sit at increasing latencies, from f000 near 240 minutes up to f384 near 380, each with its own threshold line from 250 to 481 minutes. Red markers scattered above the bands mark delayed arrivals, some reaching past 1,000 minutes.
GEFS's 16-day run, with genuinely staggered horizons: day 0 lands about four hours after init, day 16 around six and a half. That gap is what makes early warning possible — a run stuck at day 0's 250-minute threshold is in trouble four hours before the full run's deadline.

An in_flight event triggered by a lead group might be a useful warning depending on one's sensitivity to delays. Or one could subscribe to complete_delayed if they only wanted confirmed late completions.

How do delays correlate with agency advisories?

From time to time, ECMWF and NOAA, for example, issue dissemination advisories: memorable ones include the dramatic power outage impacting the Bologna data center, or the crazy summer when NOMADS FTP took early retirement (too soon?).

We now ingest these in real time and surface delays on our status and pipeline pages. We have backfilled the archive through early 2022.

Using these, we asked yet another question: Can lead-group delays detect official advisories early?

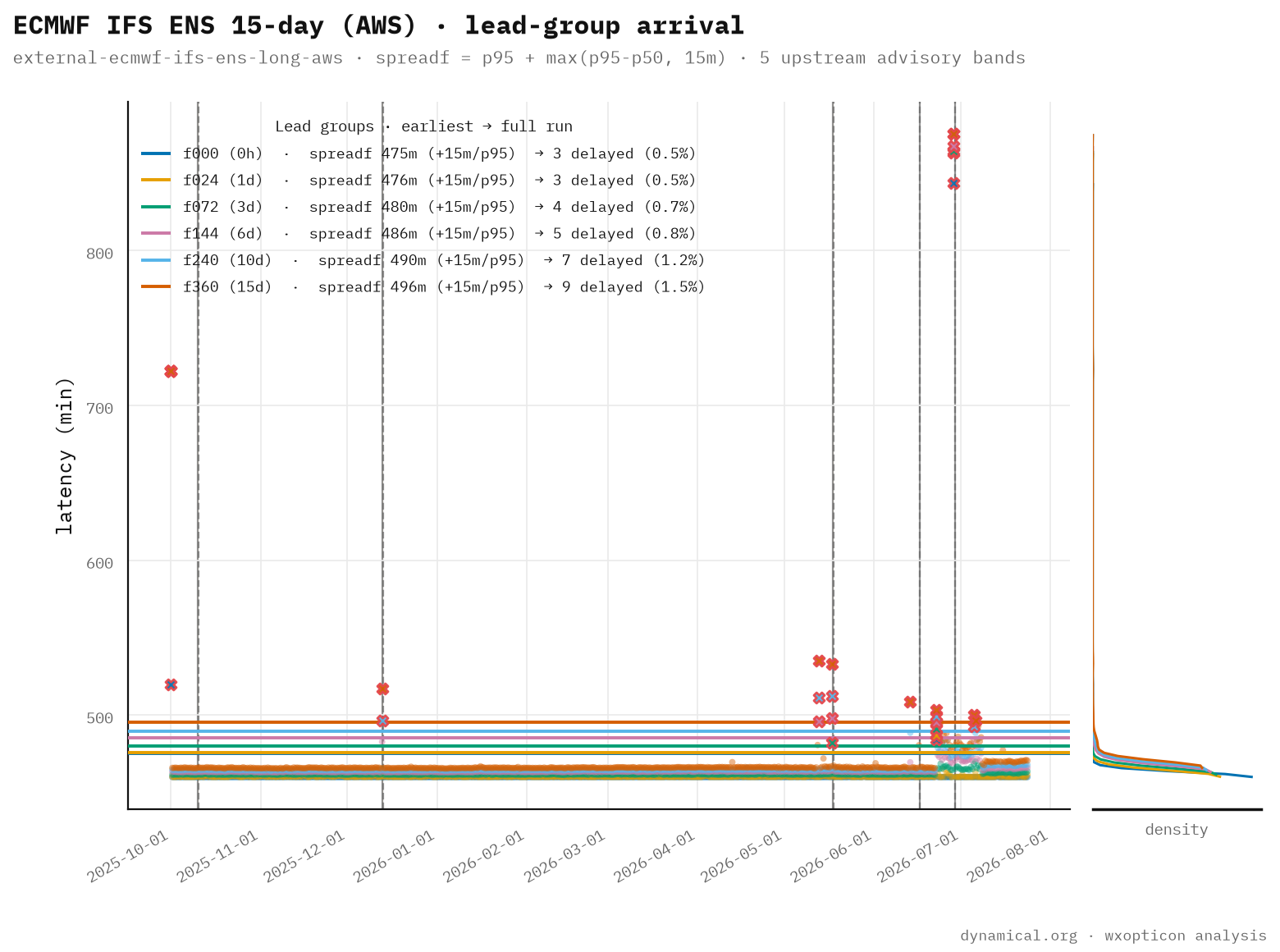

Lead-group arrivals for ECMWF's 15-day ensemble on AWS, with five vertical grey bands marking ECMWF dissemination advisories. Most arrivals sit in a flat band just under 480 minutes. Red delayed markers appear in clusters, some sitting on advisory bands and some far from any of them, with the worst reaching 870 minutes.
Five ECMWF advisories (grey) over the 15-day ensemble. Some land on runs we flagged, some on ordinary stretches, and several of our delays have no advisory at all. Even where they coincide it isn't detection — the bands sit at init time, and our alarms fired 96 and 196 minutes *after* ECMWF posted.

Not conclusively, based on the archive we have. We found 24 product/run matches with an opening agency advisory. Four also experienced a lead-group delay, and those delays followed the agency post by roughly 2, 11, 96, and 196 minutes. That is too small a sample for a broad conclusion, but it is enough to reject the claim that lead-group spreadf was an earlier advisory detector in this period.

Subscriptions and feeds

If you can expose an inbound HTTP endpoint, webhooks are a good way to be notified of specific dissemination events or delay conditions. wxopticon POSTs a signed JSON body to your endpoint the moment a run crosses a boundary you've subscribed to:

{
  "event_id": "noaa-gfs/external-noaa-gfs-aws/2026-06-10T06:00Z/complete",
  "group_id": "noaa-gfs",
  "product_id": "external-noaa-gfs-aws",
  "product_label": "NOAA GFS forecast (AWS)",
  "init_time": "2026-06-10T06:00:00Z",
  "kind": "complete",
  "lead_group": "f384",
  "lead_group_label": "16d",
  "max_lead_hours": 384,
  "occurred_at": "2026-06-10T11:12:04Z",
  "latency_s": 18724.0,
  "timing": "on_time"
}

Subscriptions are managed at status.dynamical.org/webhooks; access is currently allowlisted, so get in touch if you'd like to try it. You can even attach a small sandboxed Python function that runs against the just-arrived dataset and shapes the payload or filters out deliveries you don't want.

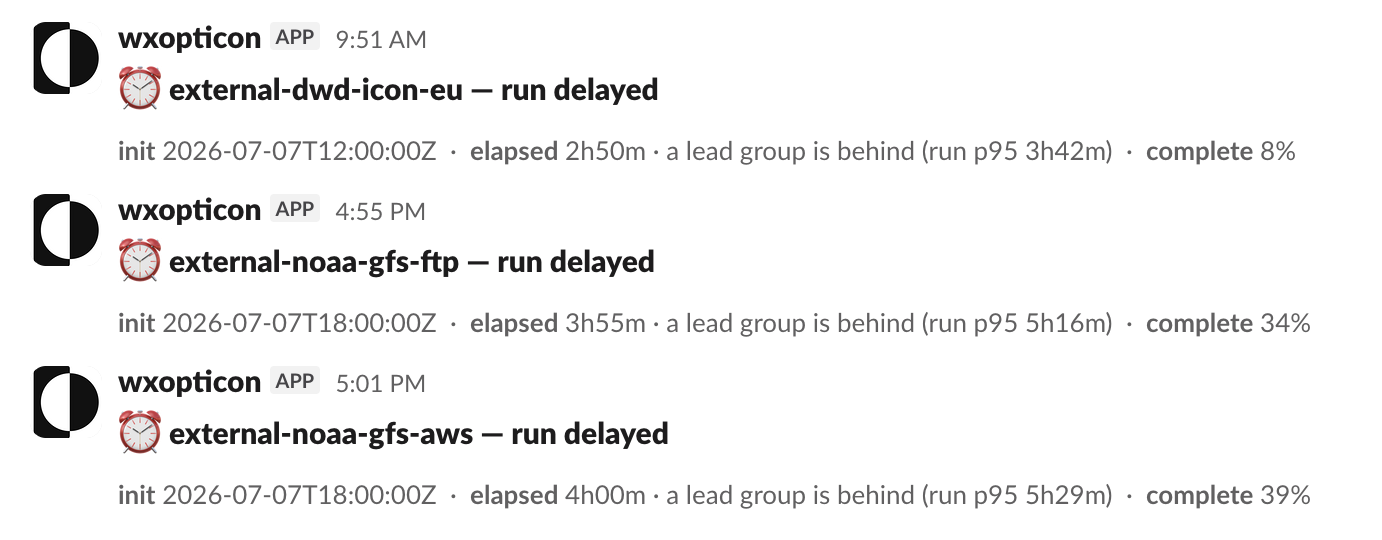

A Slack channel showing a wxopticon boundary notification delivered through an incoming webhook, with the run's product, init time, and the milestone it crossed.
wxopticon also supports Slack-style incoming webhooks, so boundaries can land straight in a channel.

For those of you who hear the soft footfall of the IT team plodding imperceptibly, but threateningly, in the distance — coming closer, ever closer at the mention of webhooks, wxopticon publishes the same events as a single JSON file you fetch on your own schedule, with no subscription or auth:

https://assets.dynamical.org/wxopticon/feed.json

It's a product-keyed snapshot. Each product carries its most recent runs, and every run nests the same discrete arrival events a webhook would deliver. Active agency advisories sit in a top-level list because one incident can span products or cycles; affected products carry references back to them.

{
  "generated_at": "2026-06-10T09:45:00+00:00",
  "products": {
    "external-noaa-gfs-aws": {
      "label": "NOAA GFS (AWS)",
      "runs": [
        { "init_time": "2026-06-10T06:00:00+00:00", "status": "in_flight",
          "completion_pct": 0.62, "timing": "on_time",
          "events": [
            { "event_id": "noaa-gfs/external-noaa-gfs-aws/2026-06-10T06:00Z/progress/f240",
              "group_id": "noaa-gfs", "product_id": "external-noaa-gfs-aws",
              "product_label": "NOAA GFS forecast (AWS)",
              "kind": "progress", "lead_group": "f240", "lead_group_label": "10d",
              "occurred_at": "2026-06-10T09:41:03Z", "timing": "on_time" }
          ] }
      ]
    }
  },
  "advisories": []
}

The nested events are identical to what a webhook carries (minus the subscription id), so the client logic is the same: select the products you care about, and dedupe on event_id across polls. The file is refreshed each five-minute cycle and served with Cache-Control: max-age=5, stale-while-revalidate=10, so feel free to slam it.

Where to go from here

We will continue to tune how "delayed" is determined. And as wxopticon now also ingests, archives, and cross-references official source advisories (an ECMWF dissemination delay, for example), we will continue to explore patterns.

wxopticon is a living but experimental piece of our infrastructure. If there's a source you'd like us to watch, or a boundary you wish you could subscribe to, let us know.

Low-latency HRRR, with all variables and levels, now in the catalog
